Western Infrastructure Failures: Over-Complication, Regulatory Gridlock, and Lessons from Historical and Modern Successes

Patrick Boyle

Summary:

The video examines why Western countries, particularly the UK, struggle with infrastructure megaprojects, often resulting in cost overruns, delays, and outright failures.

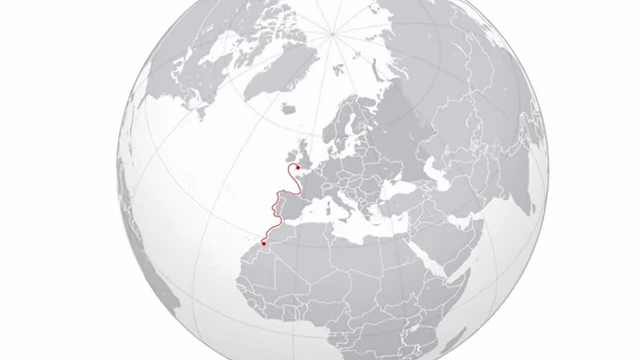

Xlinks cable route from Morocco to UK
Xlinks cable route from Morocco to UK [ 00:00:10 ]

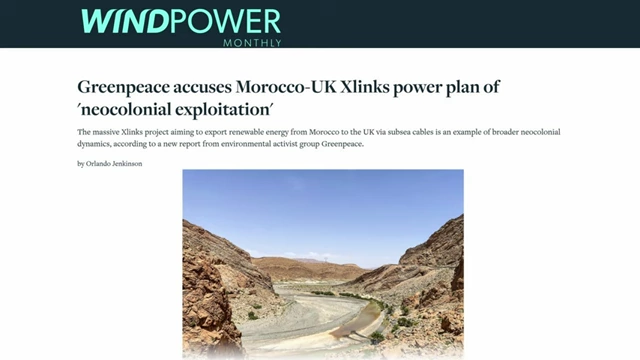

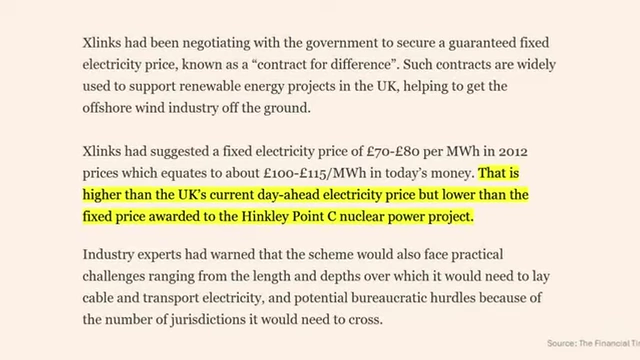

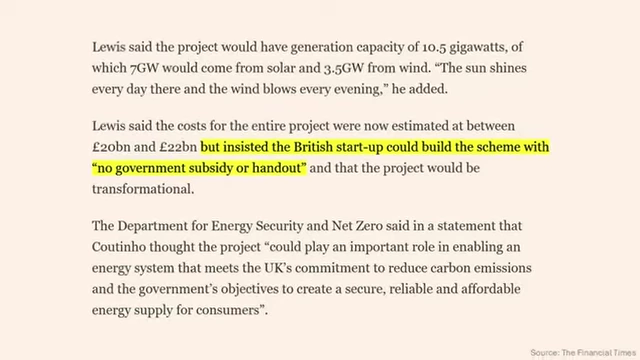

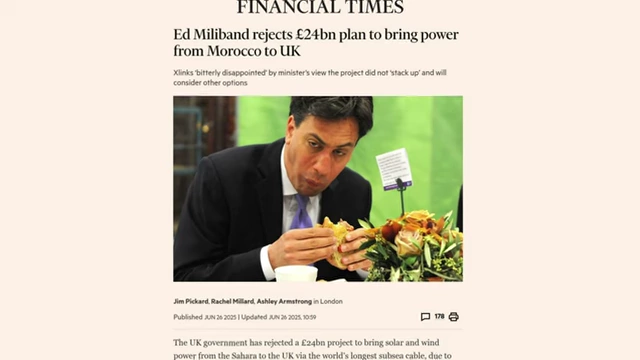

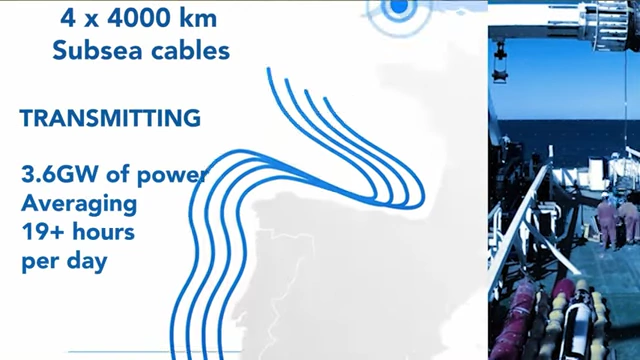

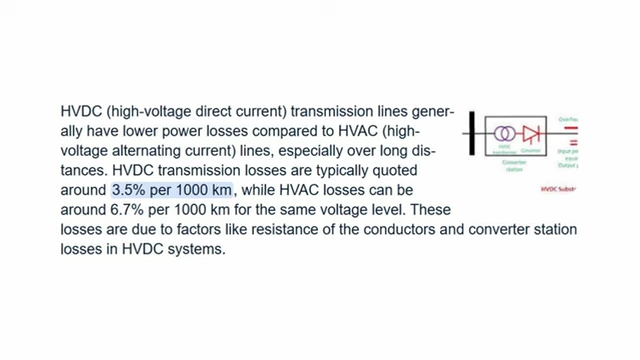

The proposed £24 billion Xlinks Morocco-UK Power Project, intended to supply 8% of the UK's electricity via a 4,000 km undersea cable from Moroccan solar and wind farms, was cancelled due to its complexity, high costs, significant energy losses (over 25%), and security concerns.

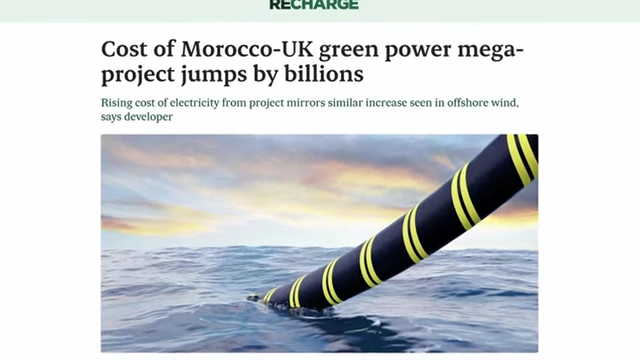

Report on Xlinks project cost increases
Report on Xlinks project cost increases [ 00:03:41 ]

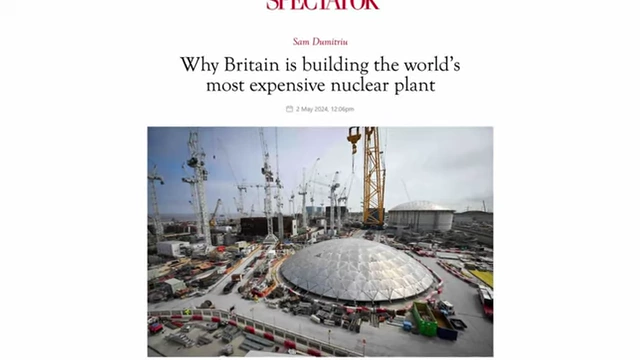

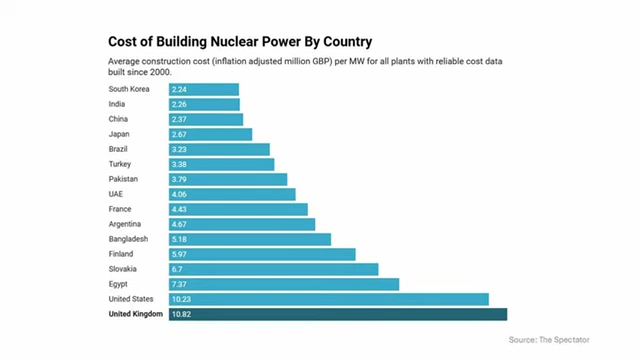

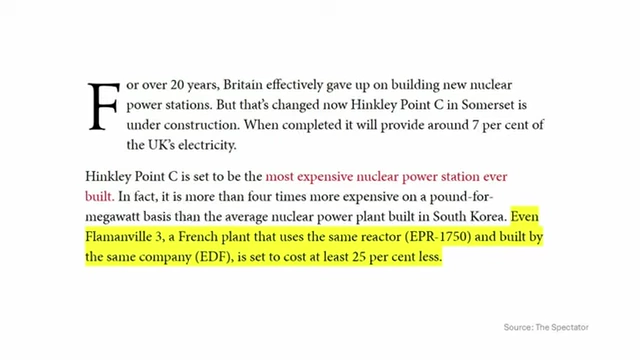

The UK's HS2 high-speed rail and Hinkley Point C nuclear plant also exemplify these issues, with HS2 costing over £100 billion and Hinkley Point C requiring extensive, costly design changes and environmental assessments.

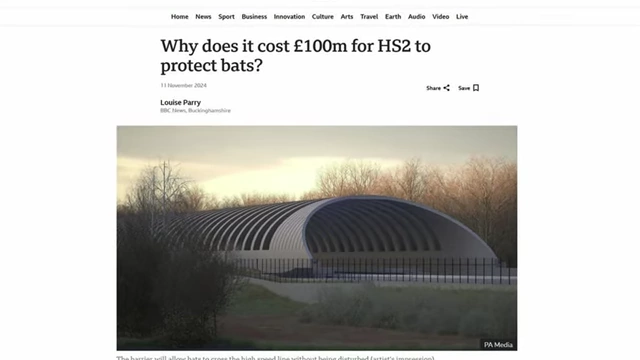

The controversial £119 million bat tunnel for HS2
The controversial £119 million bat tunnel for HS2 [ 00:05:26 ]

Bent Flyvbjerg's "Iron Law of Megaprojects" explains common failures due to over-optimism and political incentives, while David McWilliams points to "hyperdemocracy" in Western societies, where excessive veto power and regulation hinder construction.

Bent Flyvbjerg's 'Iron Law of Megaprojects'
Bent Flyvbjerg's 'Iron Law of Megaprojects' [ 00:07:59 ]

In contrast, 1920s Ireland built the world's largest hydroelectric dam (Ardnacrusha) in three years despite poverty, and modern South Korea and Madrid rapidly develop infrastructure through simplicity and replication.

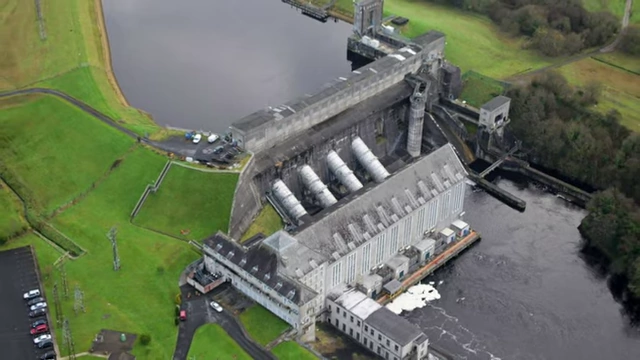

Ardnacrusha Hydroelectric Plant in Ireland (1920s)
Ardnacrusha Hydroelectric Plant in Ireland (1920s) [ 00:09:42 ]
The video advocates for a shift from grand, bespoke projects to pragmatic, modular, and replicable solutions, emphasizing speed and efficiency over spectacle to effectively address energy, housing, and economic needs.

The Failed Xlinks Morocco-UK Power Project [0:00]

The video begins by highlighting the cancellation of the Xlinks Morocco-UK Power Project, a green energy initiative designed to power the UK from the Moroccan desert.

Broader UK Infrastructure Failures [5:00]

The Xlinks project is presented as part of a larger pattern of failed megaprojects in the UK and the developed world.

The Iron Law of Megaprojects and Hyperdemocracy [7:34]

The video explores the systemic reasons behind these infrastructure failures, drawing on economic theories.

Historical and Modern Successes in Infrastructure [9:13]

Contrasting with the Western malaise, the video presents examples of successful infrastructure development.

Call for a New Approach [14:03]

The video concludes by advocating for a fundamental shift in how Western countries approach infrastructure development.
